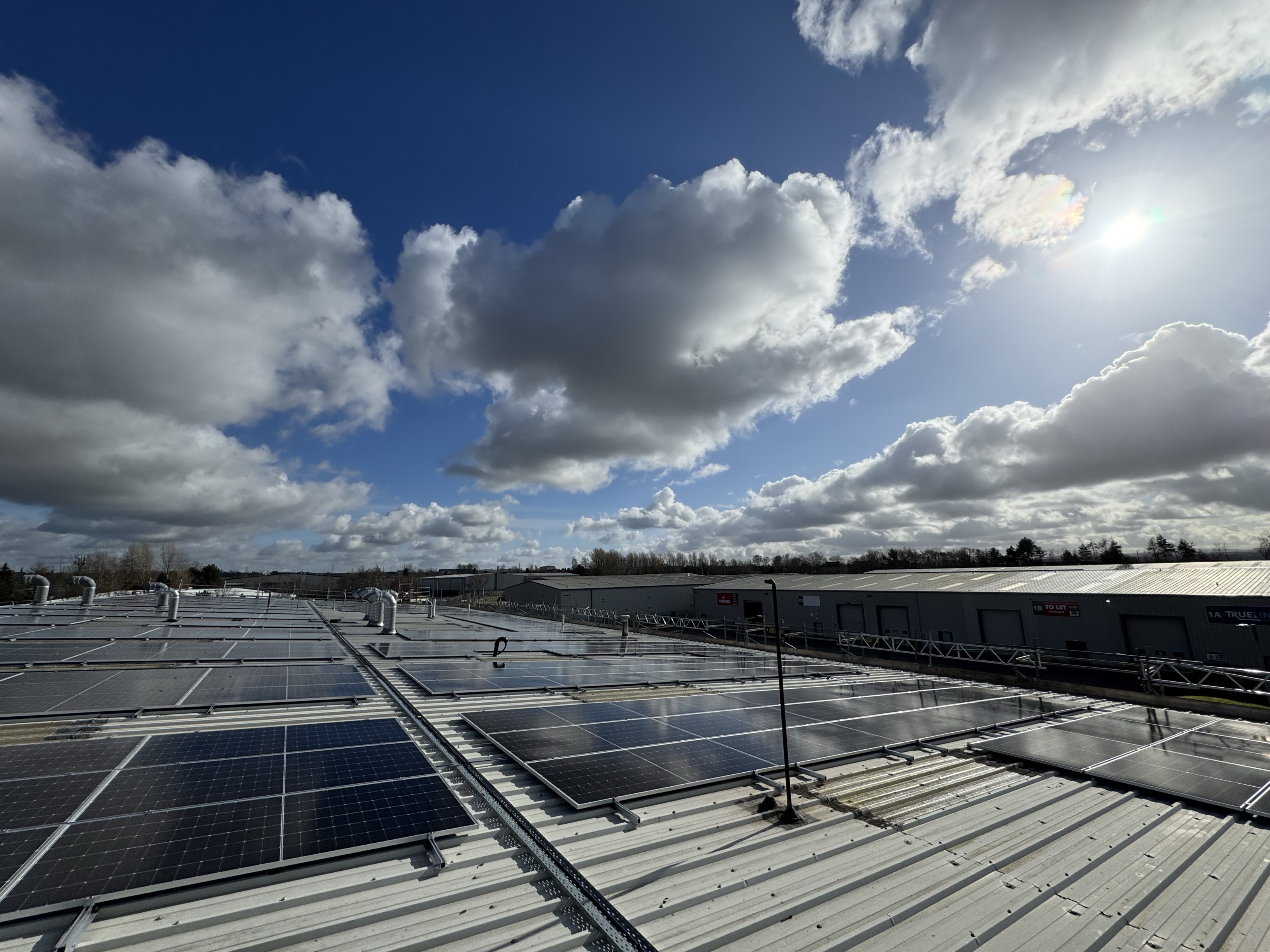

    The Solar PV installation on NHS Lanarkshire’s West of Scotland Laundry roof.

    Solution detail

    These types of energy performance projects are important because they provide assurances to our clients, and we have the confidence to guarantee that savings will be delivered as promised. It’s fantastic to see these decarbonisation schemes moving into the live phase where those savings will be realised, and these are three more fantastic contributions to NHS Scotland meeting its net zero targets.

    Kieran Walsh, Regional Manager, Vital Energi

    NHS Borders

    Our team surveyed the existing energy infrastructure at Borders General Hospital and designed a range of measures which are projected to save £279,302 whilst generating 344 tonnes of carbon reduction per year.  This was achieved through a mixture of upgrades to the lighting, HVAC, valves and building management systems as well as insulating pipework across the hospital and a few smaller satellite sites. We also delivered a 680 kWp solar array, generating clean energy and making the health board more self-sufficient.

    NHS Lanarkshire

    The health board is set to save 191 tonnes of carbon whilst achieving £172,135 of financial savings through a comprehensive mix of energy conservation measures across 2 sites which included  rooftop solar PV, heating pump upgrades and building fabric improvements such as insulation, draught proofing and door glazing upgrades.

    Two separate heat recovery systems have been added to the West of Scotland Laundry site, these bespoke systems have been designed to recover waste heat from both the internal space and mixed effluent of the washing machines.  This achieves 715,174kWh of gas savings and 122TCO2 carbon savings annually from these measures alone.

    NHS Tayside

    NHS Tayside undertook a range of measures which will reduce their carbon emissions across 3 of their sites (and councils) by 186 tonnes per year whilst saving £27,389 per annum.  To achieve this a range of energy conservation measures were installed, including 269 rooftop solar panels installed across 2 of the sites, a total of five  air source heat pumps to provide heating and hot water to each of the sites and improved building fabric performance through measures including insulation, door and glazing upgrades and LED lighting upgrades across 2 sites.

    NHS Forth Valley Completes First 12 months

    In addition to three new projects entering the monitoring and verification phase, the NHS Forth Valley energy conservation project just completed its first 12 months of being live and achieved each of its key performance indicators, saving 116 tonnes of carbon per year, almost £60,000 in energy savings and reduced energy usage by over 600,000 kilowatt hours per year.

    After securing additional funding, works were expanded to also include Battery Energy Storage Systems across three sites and an air source heat pump to further help decarbonise the Health Board’s estate.

    31 01 25 More Than 3000 Tonnes Of Carbon Savings Set For NHS Tayside Photo

    Mark Anderson Associate Director of Facilities – Property at NHS Tayside, Evan Reilly Construction Degree Apprentice at Vital Energi, David Gibson Head of New Works at NHS Tayside and Scott Roe, Project Manager at Vital Energi

    Solution detail

    Mr Walsh concludes, “These projects exemplify a fundamental step transition to Scotland meeting its net zero targets, so it is imperative that they deliver as promised and the NHS realises the full carbon savings.  We’re delighted to show our commitment to the decarbonisation of the NHS by helping to deliver four more projects which will make a real difference to the Health Boards and local communities.

  • Harvey Hudson Wins Apprentice Of The Year at Young Engineers’ Awards

    Harvey Hudson Wins Apprentice Of The Year at Young Engineers’ Awards



    Harvey Hudson Wins Apprentice Of The Year at Young Engineers’ Awards

    We are delighted that one of the first students to enrol on our Net Zero Apprenticeships programme has won the Technical Apprentice of the Year (Level 3-4) award at CIBSE’s Young Engineer Awards 2022.

    Harvey is a 2nd year Technical Apprentice with Vital Energi and studies at The City of Liverpool College. As part of his apprenticeship, he has been working in various departments ranging from work winning through to commercial and design and he is now moving onto the site-based part of his experience.

    Harvey isn’t just a great apprentice, he’s also a fantastic ambassador for apprenticeships. He’s spoken at events about the benefits of apprenticeships and to audiences ranging from school children to industry experts and he had had a real impact in promoting, not just our apprenticeship programme, but apprenticeships in general. “The first group of apprentices to enrol on our course have been wonderful. Their team ethic has been fantastic and the way they integrated into their various teams and began making valuable contributions has been inspirational. We are all very proud of Harvey for winning this award. Vital Energi are committed to inspiring the next generation of young engineers, so this has been a fantastic first year for the programme.”

    Jenny Jackson, Resource Manager – Vital Energi

    Microsoftteams Image (39)

    The CIBSE Young Engineers Awards recognise and reward the innovative thinking, hard work and skills of graduate engineers, whilst also showcasing employers who are truly committed to developing and encouraging young talent. This is the third year of the Apprentice of the Year Category, with awards being presented in a London-based ceremony on October 11th.

    Harvey spoke of his win, saying, “A lot of people have put a lot of time into developing my career and getting me to this point and I’d like to say a big thank you to them.  I’ve really felt at home since joining Vital Energi and tried to embrace every experience and opportunity and I’ve been supported by some really great people along the way.  The other young engineers on the shortlist were very strong, with some amazing achievements, so it was a surprise to win and I’m truly honoured.  I’m now looking forwards to my second year and continuing to learn and gain new experiences.”

    Solution detail

  • Handling A Shutdown & Minimising On-Campus Disruption

    Handling A Shutdown & Minimising On-Campus Disruption



    Handling A Shutdown & Minimising On-Campus Disruption

    University campuses evolve over time and need heat networks which grow and develop alongside them.  Vital Energi has been working in partnership with Loughborough University for 25 years to ensure their heat network can meet the needs of staff and students.

    We recently sat down with the University’s Project Manager, David Bell to discuss preparing for shutdowns, reconfiguring networks and how to minimise disruption on campus.

    Vital Energi: When you know you’re doing a heat network shutdown, what are your considerations?

    David Bell: Firstly, you have to consider which part of the campus is involved. Our campus is split into three areas: Central, East, and West.

    The East side consists mainly of teaching spaces and offices, so a shutdown there primarily affects staff during the working day.

    The Central campus is different as it contains most of our student accommodation. We must be very careful about how we manage that impact. Students are our clients; they pay to live on campus, and we have a duty of care to ensure they always have heat and hot water. For that reason, we schedule most Central campus shutdowns during the summer, from June through to the end of September, when far fewer people are around.

    The West side of campus has some teaching areas as well, but it also includes the Science and Enterprise Park, which is home to commercial companies renting space from us. That means close coordination is essential.

    We often plan these works years in advance, making the best use of that time. We start with initial communications to let everyone know what’s planned and then liaise with the contractor. Vital Energi handles much of the detail under our oversight, bringing their technical experience and understanding of heat network systems. Once we know the timescales and finer points, we can introduce more detailed communications and engage with stakeholders to identify and resolve any potential issues.

    VE: You’ve mentioned communications a few times now. How important are they on higher education projects?

    DB: Communications are essential.

    On this project, we were doing enabling works over the summer as part of a new 500-bed student accommodation build. A lot of the existing heat and water infrastructure ran through the area where the new buildings were going, so we had to divert those services. That also meant diverting mains cold water and both the high-voltage and low-voltage cabling.

    We held a joint meeting with Vital Energi East and other contractors to coordinate everything and make sure everyone knew who was digging where and when. The cold-water work wasn’t too disruptive as it was mostly outside the main compound, but within the compound we had HV and LV works happening at the same time.

    David Cooper, your project manager, managed that brilliantly. He kept everyone in the loop, worked with a senior lecturer to create a safe walkway through the site in case of emergencies, and even helped with bin deliveries and car park access. It’s those small details that make a big difference.

    From the initial planning stages right through to estimating and coordination, communications were spot on. The whole team at Vital delivered exactly what we’ve come to expect, which is the reason we keep working with them.

    NDT Tested Welds

    Non-Destructive Testing on the welded joints ensures the highest quality and contributes to longevity.

    Solution detail

    From the initial planning stages right through to estimating and coordination, communications were spot on. The whole team at Vital delivered exactly what we’ve come to expect, which is the reason we keep working with them.

    David Bell – Project Manager, University of Loughborough

    VE: Construction and engineering works can cause disruption, and not all projects can be delivered during the summer holidays. What levers can you pull to reduce that disruption and minimise the impact?

    DB: It depends on the project, but our long lead times make it easier to plan ahead and reduce issues. If we have an emergency shutdown outside of the holidays, for example, we work closely with our Rooms and Accommodation Department to look for solutions through timetabling.

    If a lecture was scheduled in a building without heat, we might move it elsewhere. Rooms and timetabling will always work together to avoid disrupting core teaching wherever possible.

    Our biggest concern is always the students, so we do everything possible to keep heat and hot water running while they’re here. Sometimes it can’t be helped, but careful planning and clear communication help to minimise the impact.

    It’s like a sliding scale of solutions. We aim to do everything outside of term time, but if that’s not possible, we’ll find individual solutions. Even outside of term we must be careful as graduation, for instance, is a key date that needs to be respected.

    VE: Can you give us practical examples of how you worked with Vital Energi to reduce the impact on this project?

    DB: The pre-construction period is critical. That’s when we issue communications to everyone involved so stakeholders can provide feedback before work starts.

    Vital sent senior members of staff to the pre-start meetings and developed very good relationships with our Facilities Management team, which meant everyone knew what was happening and could keep others informed. I maintain a stakeholder map to help the project team identify who they need to speak to, and we liaise closely with Security to manage access. We also have a project management board that’s updated weekly or monthly. My role is to make sure Vital has those relationships in place and that communication stays consistent.

    You can see the benefits of that planning in practice. On one occasion, there was a fire on an adjacent site, and emergency vehicles needed access through our site. Because emergency routes had already been factored in and protected at the planning stage, everything went smoothly.

    VE: So responsiveness is also important?

    DB: Absolutely. Some issues need fast resolution, and Vital are very strong in that area. Your project manager shared his mobile number with everyone who needed it and responded quickly whenever issues arose.

    Vital are also proactive in branding their site fencing with contact details, which makes it clear how to provide feedback or raise a concern, and those queries are resolved promptly.

    VE: University campuses are constantly changing and evolving. What can you do to make sure your heat network keeps up?

    DB: We’ve known for five years that we were going to build this new student accommodation, so we planned accordingly. We’ve also got a ten-year plan, which means anything we do now complements that bigger picture and is future proofed. Having a long-term view is essential.

    Old Pipework Capped Off

    Capping the original pipework as part of the reconfiguration works

    Solution detail

    VE: Are here any areas you feel are undervalued, but if you do them right, your project goes more straightforward?

    DB: We live in a world of technology, but there’s still no substitute for the personal touch. When Vital has a project, I’ll call, arrange a site meeting, have a coffee, and we go through the drawings together. That kind of open, two-way discussion sets the foundation for a good partnership.

    Everyone is flooded with emails these days, so that face-to-face contact at the start makes a real difference.  Also, that’s when you can start helping them to understand your culture.

    VE: No two campuses are the same. How much work goes into helping contractors understand yours?

    DB: That’s a really important point. Vital has been working with us for 25 years now, so they know the campus well, but that experience has built up over time.

    We have “Loughborough standards” and specifications, and most Universities will have variations of their own.  They’re all clearly set out in our ITT documents, which help contractors understand the technical expectations. But you also have to learn the culture of how the university operates.

    The project manager on this job came straight from another higher education project, but he quickly realised that methods and procedures which worked elsewhere wouldn’t necessarily work here. He listened, adapted, and came up with the right solutions for our environment.

    We also do simple things like sharing the academic calendar, identifying sensitive dates, and connecting contractors with curriculum and facilities management teams. It’s about building a full picture of how the site functions.

    VE: So trust becomes a big issue?

    DB: Absolutely. I can’t be on site eight hours a day, it’s just not realistic. My job is to communicate what’s needed, set the required standards, and then trust the contractor to deliver. I provide oversight, not micromanagement.

    That’s why experience and a strong track record are so important. Good contractors work to the right quality and standards, and we make sure that happens without needing to watch every move.

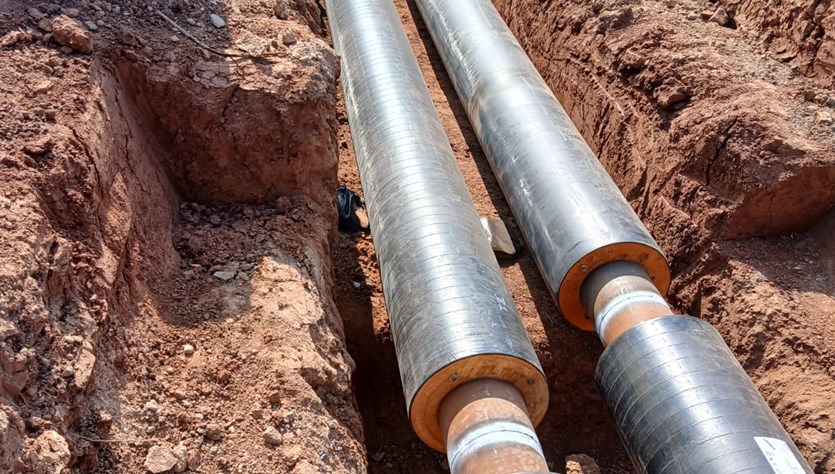

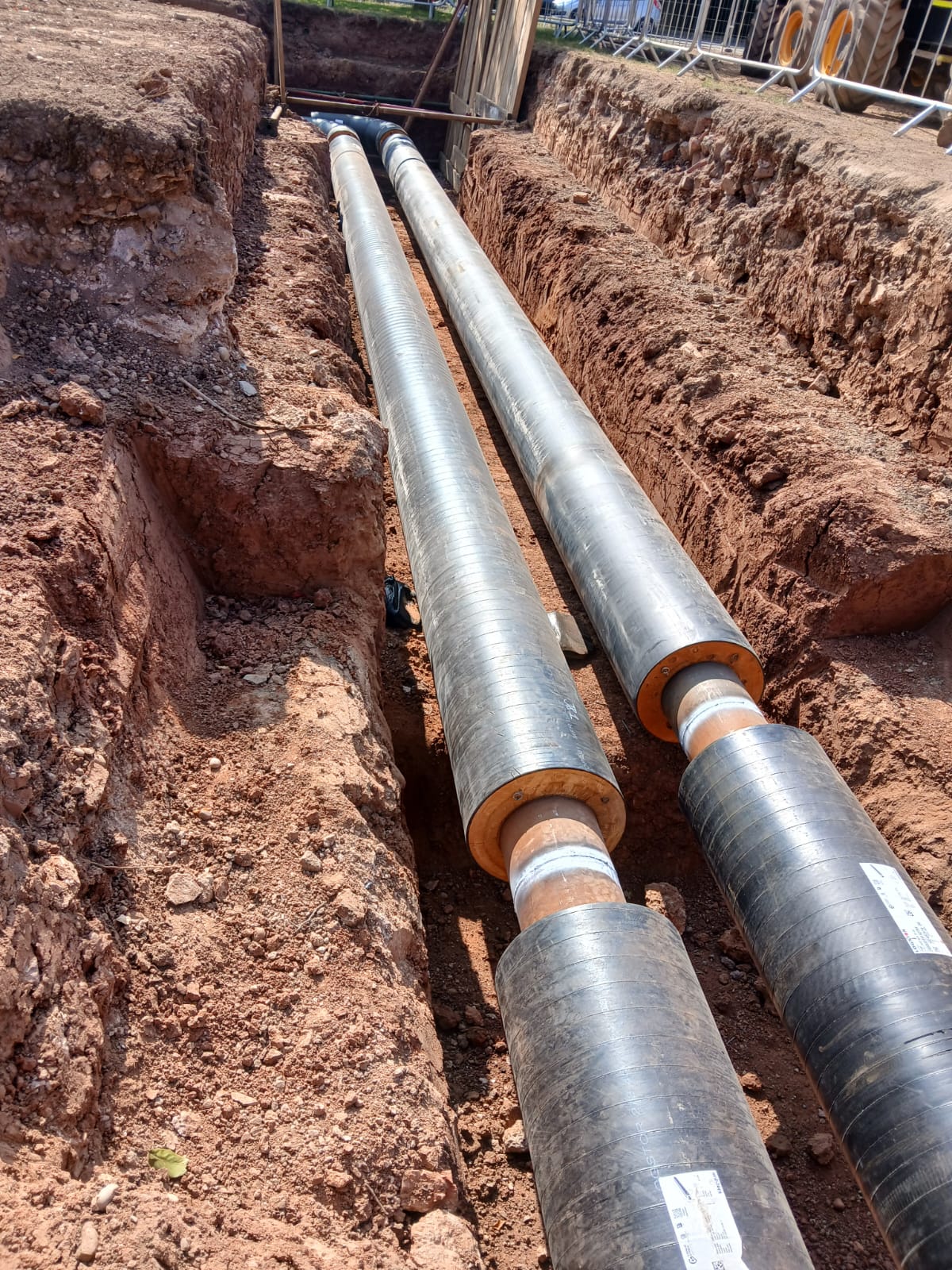

    Diversion Run

    The new 300m section of heat network being installed.

    Solution detail

    VE: If you get the invitation to tender right, does that solve many of the technical challenges?

    DB: It certainly helps. We don’t use external cost consultants; we estimate project values ourselves and apply to our special projects team for funding.

    Our framework contractors have already met the necessary standards, and the ITT documents set out the scope of works, specifications, and procedures. We assess bids on both price and quality.

    There’s always a temptation to go for the cheapest option, but that can cost far more in the long term. Especially with district heating systems, it’s important to have the right expertise… you need absolute confidence that your contractor knows what they’re doing.

    VE: How would you rate Vital’s approach?

    DB: You met every single expectation, and in some cases, you went above and beyond, which was great to see.

    VE: You’ve managed your heat network successfully for over 25 years now. What advice would you give to organisations just starting out?

    DB: Technically, I’d say build resilience into your design. Our network is designed so we can isolate certain branches and redirect heating through others. That means we can shut down parts of the system while still delivering service elsewhere, which is a big help during reconfiguration works.  You can’t overstate the importance of resilience.

    More broadly, build strong relationships with your contractors. There’s real comfort in knowing you’re working with professionals you can trust.

    Finally, don’t focus solely on price… aim for value. Budgets are tight, and value for money is essential, but long-term infrastructure has to last. Choosing the cheapest option can cost far more in maintenance, repairs, and operational issues later.
